TT20 and North Area Consolidation
TT20 and North Area Facilities
North Area (NA) experimental zone and its Transfer Tunnel 20 (TT20) are built in 1970s at the CERN Prévessin site as part of the Super Proton Synchrotron (SPS) Program. A 400 GeV continuous proton beam from the (SPS) is extracted to TT20 (and TDC2) transfer line and brought to the primary targets T2, T4 and T6 in NA. Then the secondary beam particles produced after the primary targets are picked-up by the secondary beam lines H2, H4, H6, H8, P42, K12 and M2, and transferred to the experimental halls EHN1, EHN2 and experimental cavern ECN3. The North Area hosts a wide variety of experiments, ranging from tests for R&D or detector validation purposes (for the LHC and other laboratories), to fixed target experiments (NA62, COMPASS, NA61/SHINE) and innovative future projects such as the Beam Dump Facility and the Neutrino Platform.
Today, in total 420 power converters of 25 different types are installed in the buildings BA2, BA80, BA81 and BA82. They are supplying the large variety of magnets including the small quadrupoles, dipoles distributed in the all transfer lines, the large septum in TT20 and the spectrometer magnets in the NA experimental zones. The converters are essentially built of the thyristor bridges delivering the power from 2 kW to the small quadrupole magnets up to 1.5 MW to the spectrometers in NA.

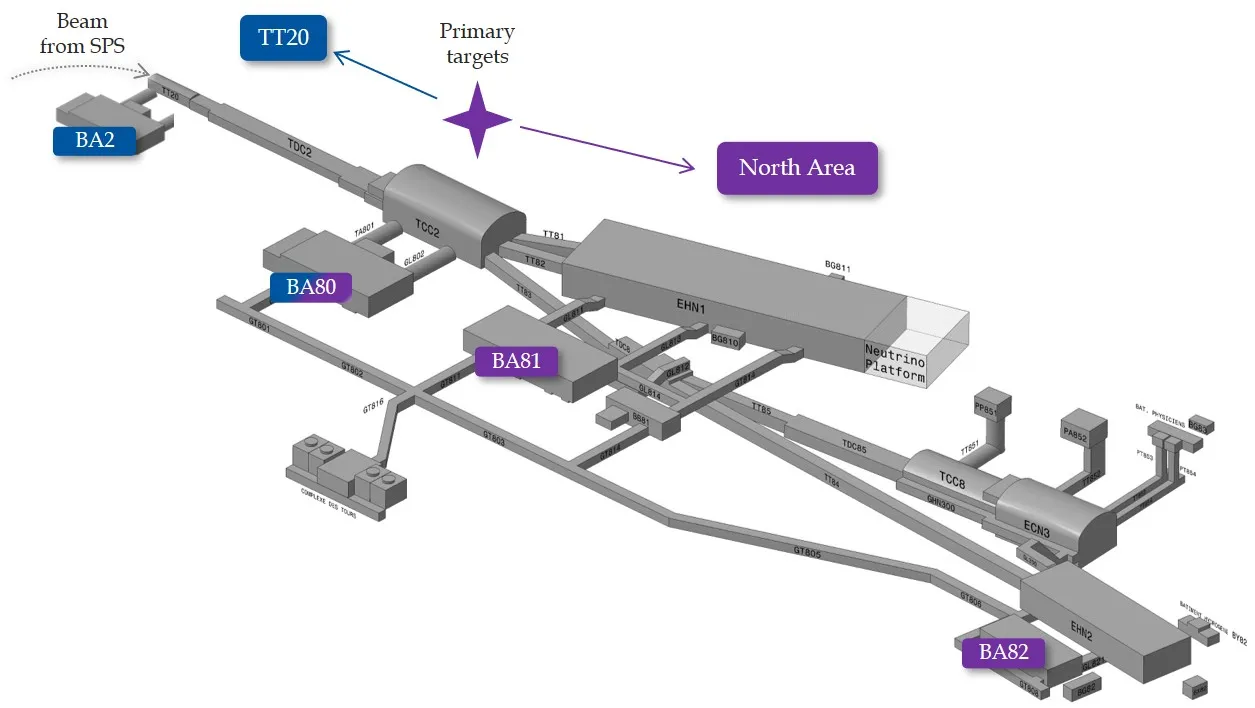

TT20 and North Area Facilities: converters installed in buildings BA2, BA80, BA81, BA82

Primary (TT20 and TDC2) and NA secondary (H2, H4…M2) beam lines and experimental zones
Consolidation Objective
The power converters in TT20 and NA are in the operation since 1975 and have exceeded the intended lifetime. The power, the electronics and the control platform have never been consolidated and have become obsolescent. With one intervention per day and increased time to repair single fault, the downtime directly caused by the converters has shown the increasing trend over the past years peaking to nearly 300 h in 2018.
Following the outcome of 2016 Chamonix Workshop highlighting the need for urgent renovation, BE-EA group sets-up the framework for the consolidation studies of the North Experimental Area. Within this framework, SY-EPC group receives the mandate to study the consolidation of the power converters focusing on the aspects of equipment standardization and energy savings. In Feb-2021, at the NA Project Approval Review Meeting, EPC proposes the Consolidation Plan for TT20 and NA Power Converters targeting the replacement of all converters with three standardized converter families: POLARIS, BOREAL and NEPTUNE.
The three converter families are targeting to supply three important set of magnet circuits in future TT20 and NA. POLARIS converter family is intended to supply the majority of circuits (~95%) requiring relatively low current and power and distributed all along primary and secondary beam lines. BOREAL converters are intended to supply large circuits such as large bending magnets in TT20 and TDC2 which bends the beam to the primary targets in NA as well as the spectrometers in experimental zones. NEPTUNE is to be deployed for two large septa circuits used for extraction of the beam from SPS ring to TT20.

I < 1000 Arms 1500 Arms < I < 6000 Arms 5000 Arms < I < 15000 Arms
The converter families and ratings: POLARIS for standard circuits, BOREAL for large circuits, NEPTUNE for ultra-large circuits
Project Team
| NA Consolidation Coordinator | Yacine Kadi |
| EPC Responsible | Ivan Josifovic |
| Team members | Yves Gaillard (deputy), Panagiotis Asimakopoulos, Frederic Daligault |
Project documentation
| TT20 & NA Powering Consolidation | EDMS documentation: CERN-191259 |
| Existing Powering Solutions | HPC webpage: General Spectrometer power converters: GOLIATH (H4), MNP33 (K12), SM1 (M2), SM2 (M2) |
| NA Consolidation Study Background Documentation (BE-EA) | NA-CONS AC-CONS Day: edms. 2259707 NA-CONS Report: edms. 2042932 NA-CONS Addendum: edms. 2144442 |
| Power Converters Work Package Description | Consolidation Request: edms. 2488121 |
| NA Project Approval Meeting | Indico: event. 1006952 Power Converters Presentation: edms. 2487963 |
| Project Planning | GDPM: edms. 2457610 |
| Powering Consolidation Strategies | POLARIS strategies presentation at EPC: edms. 2420942 |
| Material and manpower resources for POLARIS, BOREAL and NEPTUNE | Resources summary presentation at EPC: edms. 241762 |
| Prospective Contract Values | Power stacks, magnetics, crates… contracts: edms. 2268413 |
| Memorandum on application of ISO50001 requirements | .edms |
| Power Converters Specifications | POLARIS: .edms BOREAL: .edms NEPTUNE: .edms |
| EXTERNAL SERVICES | |
| Electrical Mains Infrastructure Requirements | POLARIS: edms. 2472159 BOREAL: NEPTUNE: |
| Water Cooling Infrastructure Requirements | POLARIS + BOREAL + NEPTUNE: |
| Building Floor Infrastructure Requirements | Proposal for Removal of Terminal Boxes in BA80: edms. 2443686 Preliminary Converters Layout in BA80: edms. 2425727 |

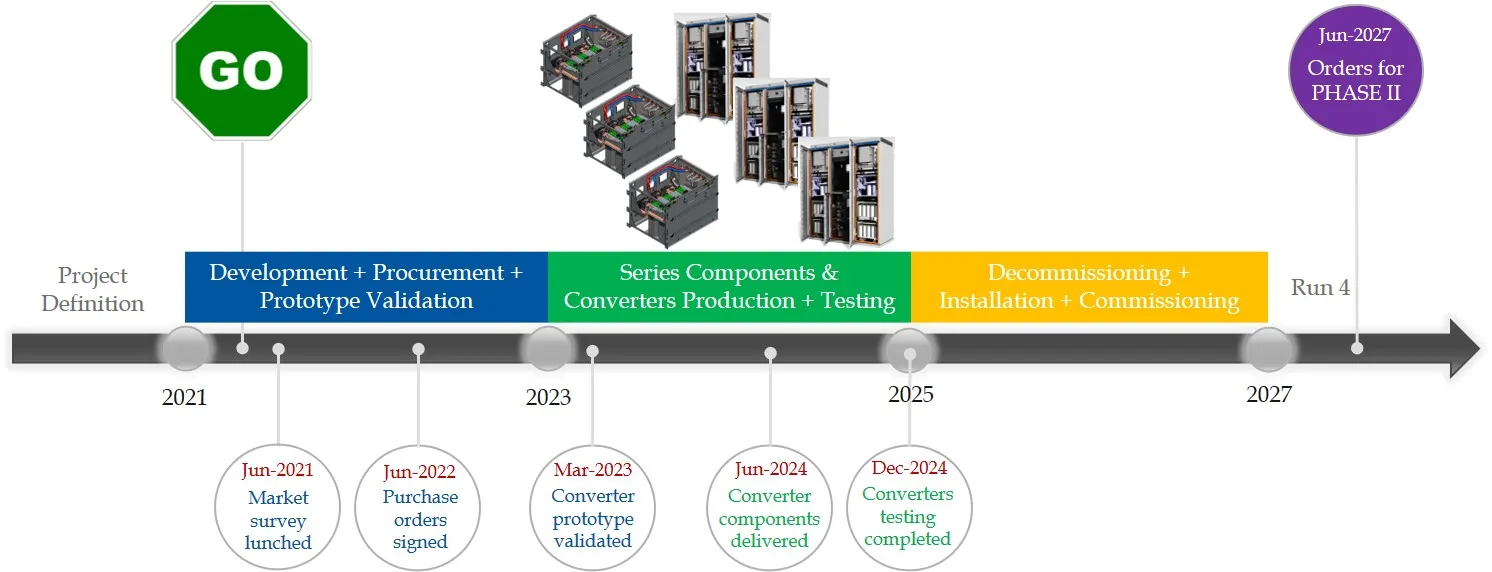

Project Timeline

The project timeline and milestones
